Water Capacity Constraints Are Halting Growth in Waterloo Region

New development approvals across the region have paused due to water servicing limitations in the Mannheim service area. The industry is aligned on the issue — and ready with solutions.

A Coordinated Industry Response

Reopen Waterloo Region is a joint industry alliance advancing water capacity solutions to get Waterloo Region open again.

Waterloo Region Leaders across construction, development, and the real estate sectors have come together to present a unified, solutions-focused response.

This coalition is aligned on the urgency of the issue and committed to working collaboratively with Regional Council and the Province to move forward.

Our mission is to:

  • Restart Development

  • Restore Investment

  • Renew Growth & Prosperity

The Issue!

In December 2025, the Region of Waterloo confirmed a water capacity constraint in the Mannheim service area—impacting Kitchener, Waterloo, and parts of Cambridge, Woolwich, and Wilmot.

As a result, the Region has paused new servicing agreements, resulting in a de facto freeze on development approvals.

Tens of thousands of new housing units currently in the planning process are at risk of delay.

Time is of the essence. Continued delay will further erode housing supply, economic growth, employment stability, and investor confidence in Waterloo Region.

Why It Matters:

Economic & Community Impacts:

  • Reduced housing constraints, amplifying an exisiting and ongoing housing and development crisis

  • Higher construction costs, passed on to buyers and renters

  • Delayed growth-related capital projects and infrastructure investment, sue to loss of regional development charge revenues

  • Loss of skilled trades and construction workers to other jurisdictions

  • Increased legal exposure where existing service agreements guarantee capacity

  • Reduced economic competitiveness, reduced and talent attraction and a weakened economy for Waterloo Region.

Key Technical Concerns:

Industry stakeholders have identified several concerns with the current approach:

  • Introduction of a 20–30% resilience buffer without prior industry consultation or approval

  • Reliance on modelling based on extreme and unlikely scenarios

  • Use of non-transparent criteria to define “sustainable groundwater capacity”

  • Double-counting of risk factors already addressed through provincial permitting

  • Loss of up to 40% of intended capacity at the Mannheim facility due to overlapping constraints

  • Limited consideration of interim engineering solutions, such as pumping or system adjustments

A Practical Path Forward:

Viable solutions are available — and can be implemented quickly.

  1. Implement a risk-based interim approach
    Balance system resiliency with measured allocation to new development

  2. Deploy existing infrastructure funding
    Utilize nearly $100M in available development charge reserves

  3. Advance shovel-ready projects
    Prioritize projects already identified in the Region’s capital plan

  4. Reassess water supply opportunities
    Review past well studies and test production potential

  5. Expand system connectivity
    Strengthen regional interconnections to improve resilience

  6. A justifiable methodology for allocating additional new capacity with a clear and consistent framework for implementation at the local level.

  7. A return to normal permit issuance once a realistic resiliency target is achieved

A Critical Moment for Action

The upcoming Regional Council discussions represent an important opportunity to take coordinated, evidence-based action.

Delays will continue to impact housing supply, economic growth, and investment across Waterloo Region.

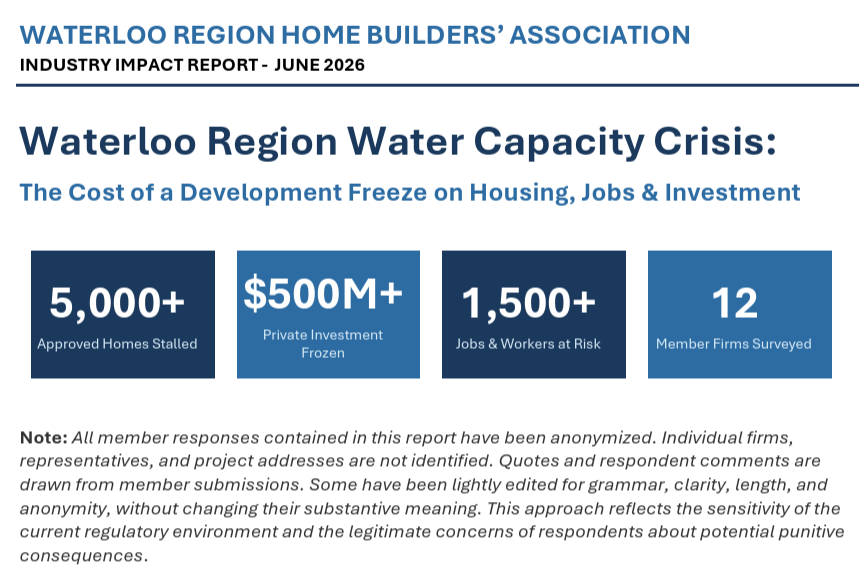

Waterloo Region Water Crisis Stalls 5,000+ Approved Homes, Freezes Over $500M in Investment, Puts 1,500+ Jobs at Risk

Source: Waterloo Region Home Builders Association (website)

WRHBA survey of 12 member firms reveals scale of development freeze and demands immediate action from the Region.

KITCHENER, ON I JUNE 1, 2026 A development freeze triggered by a failure to manage water supply capacity at the Mannheim Water Treatment Plant is preventing thousands of approved homes from being built across Waterloo Region, costing jobs, stalling hundreds of millions in private investment, and eroding the Region’s reputation as a destination for housing investment.

That is the finding of a new survey conducted by the Waterloo Region Home Builders’ Association (WRHBA), which gathered responses from 12 member firms representing thousands of units currently blocked from construction despite having full planning approvals in place.

“The homes are approved. The money is committed. The demand is real. The only thing missing is water, and that is the Region’s responsibility. Each week this freeze continues imposes real financial losses on our members, job losses across the trades, and delayed homes families are waiting for.”
- Marie Schroeder, CEO, Waterloo Region Home Builders’ Association

Key Facts from the Survey

  • Over 5,000 residential units are directly stalled across 12 member firms, spanning Kitchener, Waterloo, Elmira, St. Jacobs, and rural Woolwich.

  • Total frozen private investment exceeds $500 million, including multiple projects where institutional equity partners have withdrawn or are actively considering reallocation to other regions.

  • More than 1,500 construction trades, contractors, and workers are affected; some businesses have already closed.

  • A federal CMHC Apartment Construction Loan Program application, eight months in preparation, is at risk of being redirected to another Canadian city because the project cannot demonstrate shovel-readiness.

  • The Region has provided no clear timeline or allocation framework for when projects will be permitted to proceed.

  • Projects are blocked at every stage of the pipeline, from subdivision registration through to building permit issuance.

Human Impact

Survey respondents described real, immediate consequences: tradespeople whose businesses have closed, families waiting for homes that cannot be built, a congregation whose housing project now risks bankruptcy, and long-term care operators who have walked away from housing partnerships because of the uncertainty.

“This is a catastrophic failure of mismanagement by the Region at the worst possible time. Missing this opportunity could result in irreparable harm to local homebuilding, development, and professional consulting firms while also significantly limiting new home supply for the foreseeable future.” - Survey respondent, Waterloo Region developer

WRHBA Is Calling For

  • Immediate publication of a transparent water capacity allocation framework with clear criteria and timelines.

  • Issuance of conditional building permits for projects that have already received all required planning approvals.

  • An emergency meeting with the Region, area municipalities, and the development industry

  • Accelerated Mannheim Water Treatment Plant expansion with a public construction and commissioning schedule.

The full WRHBA Industry Impact Report accompanies this release as a separate document. All survey responses have been anonymized in compliance with privacy requirements to ensure member protection.

Executive Summary

Waterloo Region is facing a self-inflicted housing and economic crisis. A failure to proactively manage water supply capacity at the Mannheim Water Treatment Plant has triggered a de facto development freeze across the Region, blocking thousands of approved, shovel-ready homes and threatening hundreds of millions in private investment at the worst possible moment.

The Waterloo Region Home Builders Association (WRHBA) surveyed 12 member firms in April and May 2026 that are directly impacted by the Region’s freeze on new development. Their responses paint a consistent and alarming picture: projects are stalled at every stage of the development pipeline, investors are withdrawing capital, trades are laying off workers, and confidence in the Region as a place to do business is eroding rapidly.

This is not a housing market problem. This is an infrastructure governance failure. The homes are designed. The approvals are in place. The private money is committed. The only thing missing is water.

Key Findings

  • Over 5,000 residential units are directly impacted across all 12 respondents

  • Estimated frozen private investment exceeds $500 million across the Region

  • More than 1,500 trades, contractors, and workers are affected

  • Individual firm impacts range from $5M to over $120M in stalled activity

  • Equity partners are withdrawing; institutional lenders are tightening in the Region

  • A federal CMHC housing finance application eight months in preparation is at risk of reallocation to another city

  • The Region has provided no clear timeline or allocation framework for when holds will be lifted

  • Every respondent expressed willingness to participate in a coordinated advocacy campaign

At Issue:

The Mannheim Water Treatment Plant is the primary water supply source for the City of Kitchener, the City of Waterloo, and parts of Woolwich Township. In late 2025, available treatment capacity at the plant proved insufficient to support both existing demand and the volume of approved, pipeline residential development.

The Region of Waterloo responded by imposing a moratorium on new servicing agreements and building permit issuances tied to the Mannheim service area. This freeze was applied broadly, affecting projects at virtually every stage of the development pipeline, from draft plan registration through to building permit issuance.

The freeze was applied to projects that had already received full planning approvals and, in some cases, had received written servicing clearance from the Region itself as recently as January 2026. No clear timeline or allocation framework has since been communicated to affected parties.

The timing is acutely damaging. Both federal and provincial governments have recently introduced housing supply relief measures, including HST/GST rebates, development charge reductions, and new CMHC financing programs. These incentives require shovel-ready projects. The Region’s freeze is actively preventing local developers from accessing support that other Ontario municipalities are leveraging.

“This is a catastrophic failure of mismanagement by the Region at the worst possible time. The housing crisis was already crippling our development and construction industries without this issue. Now that multiple levels of government have begun to acknowledge the crisis and offer relief, it is imperative that the Region ensure that shovels can get in the ground. Missing this opportunity could result in irreparable harm to local homebuilding, development, and professional consulting firms.” - Waterloo Region developer, survey respondent

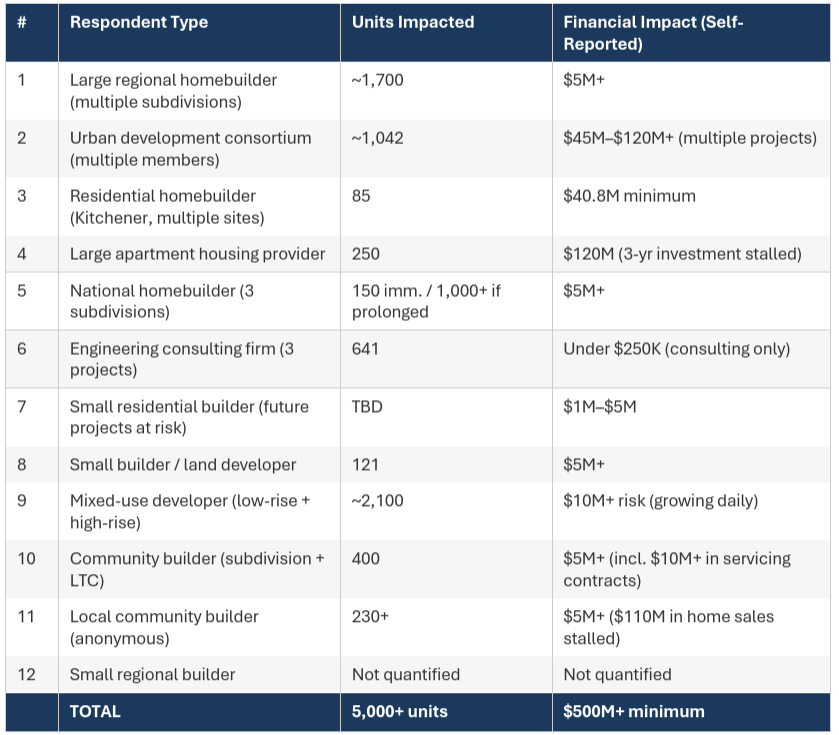

Findings: Aggregated Member Survey Results

The following findings are drawn from survey responses submitted by 12 WRHBA member firms between April and May 2026. All identifying information has been removed. Figures are reported as submitted by respondents.

1. Scale of the Development Freeze

The freeze is touching every stage of the development pipeline simultaneously, from draft plan approval through subdivision registration, servicing agreements, site plan approval, and building permit issuance. No stage has been exempted.

2. Economic & Financial Impacts

Because land financing, property taxes, consultant retainers, and insurance continue to accumulate while projects cannot proceed, every month of delay deepens the financial damage to individual firms, and to the Region’s tax base.

  • One apartment project is incurring approximately $60,000 per month in carrying costs due to the delay alone

  • A committed institutional equity partner withdrew from a 264-unit rental project specifically because of uncertainty created by the freeze; replacement equity has become significantly more difficult to secure, as investors now perceive elevated timeline and policy risk in Waterloo Region

  • A fund-financed $45–50M project sits under fiduciary obligations to reduce entitlements risk; capital may be reallocated to other regions if the issue is not resolved

  • A large apartment housing provider has stalled a $120M, three-year construction investment; a multinational partnership has been placed on hold • One local builder reported that $30M in completed subdivision infrastructure, roads, underground servicing, community infrastructure already built, is effectively stranded, with $110M in home sales unable to proceed

  • One developer’s upside risk is $10M and growing daily; several others estimate $5M+ in carrying costs and lost revenue

  • Prolonged delays are deferring millions in development charge collections, building permit fees, and future property tax revenue from the Region and area municipalities

“The uncertainty is as damaging as the restriction itself. Lack of clear timelines or allocation criteria is making it difficult to plan, finance, and commit to future development.” - Survey respondent, mixed-use developer “The money does not immediately flow back in once the taps are turned on. The investment dollars get allocated outside of the community more and more the longer it takes.”
- Survey respondent, large apartment housing provider

3. Employment & Workforce Impacts

Larger stalled projects commonly reported 150+ trades, contractors, or workers affected, while smaller projects reported impacts ranging from 0–75. In aggregate, the submissions point to a broad employment impact across trades, consultants, suppliers, and contractors. The cumulative effect across all respondents represents a significant and ongoing suppression of local construction employment.

  • Contractors have explicitly communicated to developers that they are no longer purchasing new equipment due to uncertainty about future work pipelines

  • Mechanical contractors and general contractors in the residential sector have indicated they need to lay off staff

  • One small developer reported that his excavation company, heating company, and electrician have gone out of business amid the delay.

  • One project alone, a 230-unit community development, is estimated to affect over 1,000 direct and indirect jobs across the construction supply chain

  • A 28-storey rental tower on the LRT corridor would have supported approximately 60 construction jobs over 28 months; those jobs are now indefinitely delayed

  • One small engineering consulting firm reported that the freeze accounts for up to 5% of annual revenues and has resulted in a reduced 2026 workforce

  • Developers have delayed hiring, deferred new contracts with trades and suppliers, and instructed contractors to hold off on advancing servicing work

4. Market & Community Impacts

The freeze is not an abstract infrastructure problem. Real families and communities are experiencing real consequences now. • Homebuyers are experiencing delayed closings, particularly on accessory residential units (ARUs) in Waterloo

  • Lenders are tightening financing conditions for projects in the Region, compounding the viability problem for developers already carrying increased costs

  • Active discussions with long-term care operators for a 5-acre parcel within a community development have collapsed; those partnership opportunities have disappeared

  • A multi-residential project on a former church property in Elmira, designed to provide the congregation with dedicated space within the development, now faces the risk of bankruptcy and total cancellation

  • A 2,000+ unit mixed-use development at a major Kitchener intersection cannot advance to marketing, delaying significant supply in a high-demand urban corridor

  • Federal HST rebate eligibility timelines are at risk, developers cannot access provincial and federal housing incentives because construction cannot begin

  • Raw land values in the Region are declining and land market activity has effectively frozen; one respondent reported no sales of raw land in the preceding three months

  • Market interest and purchaser traffic are well below normal conditions, driven in part by the significant negative publicity surrounding the Region’s current position

“My land is now effectively a cornfield. Banks are not lending because of the uncertainty, or if they do, they are charging premium rates. I asked my appraiser about land values and was told there have been no sales of raw land like mine in the last three months. This indicates land values are dropping, and nobody is buying.”
- Survey respondent, small builder and land developer

“We were in active discussions with several long-term care operators regarding the sale of a parcel within one of our communities, and those opportunities have since disappeared. Lenders are also becoming increasingly reluctant to finance certain projects in the Region.”
- Survey respondent, community builder

5. Governance & Policy Failures

Survey responses identified specific governance failures that have compounded and prolonged the crisis beyond what the water capacity constraint alone would warrant.

  • No allocation methodology has been communicated: developers do not know when, how, or in what order water capacity will be released. The absence of a transparent framework is itself causing harm, as it prevents financial planning, investor commitments, and sequencing decisions

  • Contradictory communications: at least one respondent received written servicing clearance from the Region confirming conditions were met, and was then blocked weeks later when the freeze was imposed. The project was within weeks of full site plan approval at the time

  • Refusal to issue conditional permits: multiple respondents noted that municipalities have declined to issue conditional or provisional building permits that would allow construction to begin while the water issue is resolved

  • CMHC financing at risk: a federal Apartment Construction Loan Program application, eight months in preparation, is at risk of being reallocated to another Canadian city because the project cannot demonstrate shovel-readiness; the program is nationally competitive and funding does not wait

  • Planning authority fragmentation: the provincial download of planning authority from the Region to lower-tier municipalities has created inconsistency in how the crisis is being managed across jurisdictions, with not all municipalities adhering to the framework the Region had in place

  • Regional staff have been providing meetings but no definitive answers or timelines to developers who have engaged directly

“We have delegated at Regional Council numerous times, between both general Council meetings and the Sustainability, Infrastructure and Development Committee. The consistent response has been that building permits cannot proceed until the regional water capacity issue is resolved, with no timeline provided.”
- Survey respondent, community builder

“They give us face time, but no definitive answers. Stressing the economic impacts of the development freeze is critical. Lost confidence in our region means investments will go elsewhere. The Region will not reach its growth targets, property taxes could go up, and DC revenue to fund projects will be reduced.”
- Survey respondent, national homebuilder

6. Investor Confidence & Capital Flight

Several respondents raised alarm specifically about the long-term investment climate implications of the freeze, distinct from the immediate project-level impacts. This is perhaps the most consequential dimension of the crisis, because the damage to investor confidence outlasts the resolution of the water issue itself.

  • Institutional investors with fiduciary obligations are beginning to view Waterloo Region as a jurisdiction with elevated entitlements risk, and are allocating capital elsewhere

  • A major multinational investment partnership has been placed on hold pending resolution; capital committed to the Region may be permanently redirected

  • The freeze perception is materially impacting investor confidence beyond those directly affected; the signal being sent is that infrastructure constraints may persist for years

  • Land values are declining and the land market has effectively stalled; the Region’s land price trajectory will lag the resolution of the water issue

  • Some job losses in the construction sector have already occurred, with the risk of additional losses growing the longer the freeze continues

    “This will likely have an impact on land prices and deals as interest in investment in the community dwindles and shifts to other municipalities. The money does not immediately flow back in once the taps are turned on, investment dollars get allocated outside of the community more and more the longer it takes.”

    - Survey respondent, institutional investor

Water Supply Update – Waterloo Region: Where Things Stand

Source: Joseph Puopolo, Co-Chief Executive Officer, Polocorp (LinkedIn)

If we’re being candid, this has been a frustrating process.

We are now almost 6 months into this process. There is still no confirmed available servicing capacity, no defined timeline for allocation, and building permits remain dependent on unresolved capacity confirmation.

That has created real uncertainty across the development pipeline. That said, there are signs that work is progressing—and a path forward is starting to take shape.

What’s been advanced:

✔️ Focused attention on water as the primary issue – Water capacity is now clearly the central constraint shaping growth decisions across the Region.
✔️ System repairs and optimization underway – Ongoing well optimization, repairs, and operational improvements are being advanced to stabilize existing supply.
✔️ Key projects moving forward – Mannheim sidestream ultrafiltration, Maple Grove Water System, Greenbrook WTP, and Grand River supply projects are all advancing at different stages.
✔️ New allocation framework introduced – A Regional policy is being established to allocate water to municipalities, initially on a quarterly basis as capacity becomes available.
✔️ Municipal and industry working groups active – Ongoing coordination between the Region, municipalities, and the development industry is helping move technical and policy solutions forward.

What’s still to come:

🔜 Actual release of capacity – To date, no net new development has been enabled through confirmed water allocation.
🔜 Clear allocation amounts and schedules – There is still no defined baseline capacity, release schedule, or timing for first allocations.
🔜 Municipal implementation – The allocation policy shifts responsibility to municipalities, but local prioritization frameworks are still to be determined.
🔜 Data transparency – Critical information around available capacity, reserved vs. allocatable supply, and prioritization criteria is still needed to support informed decisions.
🔜 Clarity in decision-making – There remains a gap between Regional control of water and municipal control of planning approvals, with no clear protocol at the permit stage.

Key upcoming milestone:

➡️ On June 3rd, Regional Council will consider the Interim Risk Management / resiliency framework.

This decision will be critical—it will determine how much water can be safely released to municipalities, and ultimately how much development can move forward in the near term.

I recommend all within the industry and community come out to discuss how important this is to the future of our community. We need to keep pushing, working with staff and council to get this to completion.

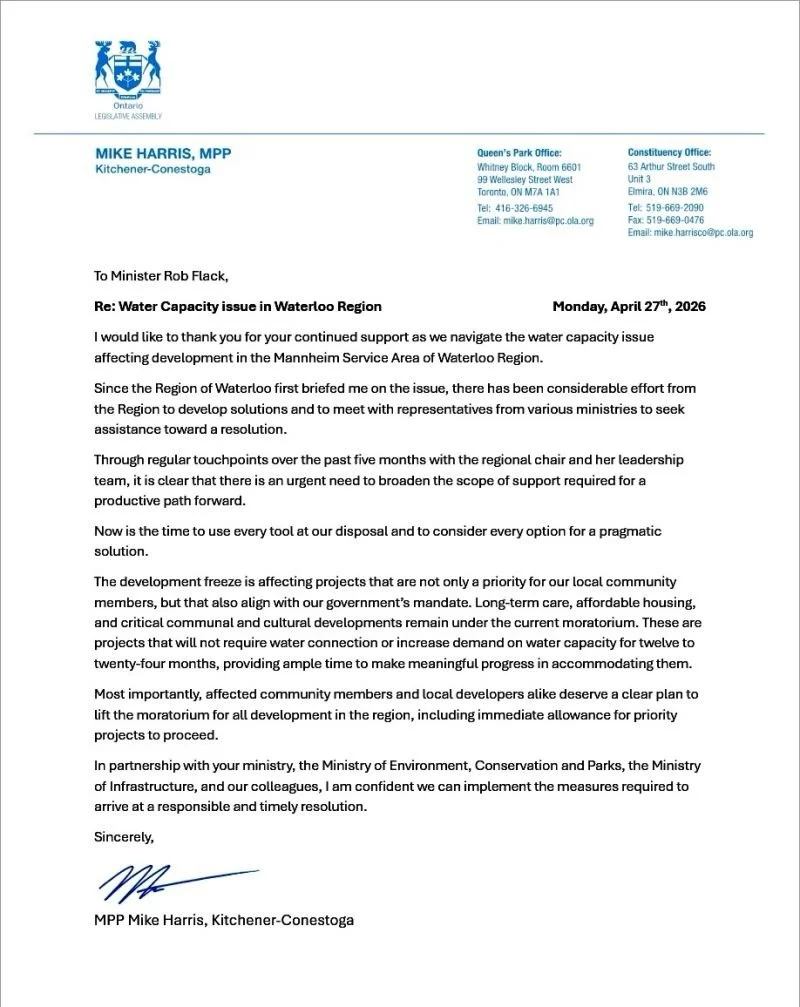

MPP Mike Harris Letter to Minister Rob Flack

Source: Mike Harris, MPP for Kitchener–Conestoga (LinkedIn statement)

This week I sent a letter to Minister Rob Flack outlining my concerns with the Region of Waterloo's water capacity issue.

“We need a concrete plan and pathway to greenlighting priority projects and meeting municipal housing targets. I've asked the Minister to explore all possible options to move things forward in a positive, collaborative way”.
